What is a building’s core factor and why should you care?

Experience! Reliability! Expertise!

O





First things first.  Let’s get a few definitions down.  I have simplified these definitions, there are some nuances which I will not go into here.  If you require a deeper understanding, BOMA, the Building Owners, and Managers Association are the generally accepted authority on space measurement.  Most quality leases will reference ANSI/BOMA standard for calculating square footage.



Usable Square Feet:

The usable square footage (USF) is the actual space a tenant will use to conduct business.  In essence, this is the space within your suite.



Common Areas:

The common area, are those areas of the building that are available for all the occupants.  Areas such as the main and elevator lobbies, public restrooms, janitor closets, electric and mechanical rooms, common phone closets and loading dock.  Collectively these areas make up the common area.



Core Factor:

Generally expressed as a percentage of the difference between the Usable and the Rentable Area of the building.  This core factor is sometimes referred to as the Load Factor and can be expressed as a multiplier 1.15 or a percentage 15%.



Rentable Square Feet:

The rentable square footage (RSF) is the usable square footage plus the pro-rata share of the common area.

How do we use this information to in determining the best value?

A building with a total square footage of 115,000 which is made up of 15,000 square feet of common area and 100,000 square feet of usable area you have a 15% core factor calculated as:

115,000 RSF/100,000 USF = 1.15 or 100,000x1.15=115,000 RSF

Let’s say you wanted to lease space in the above building “A” with its 15% core factor.  You have a proposal from the Landlord for 10,000 RSF at $30.00 per square foot.  This would be an annual rent of $300,000.00.  Your usable square footage is 10,000/1.15=8,695.65 USF.  Your annual rent on a usable basis is $300,000/8,695.65=$34.50 per USF.  A shortcut to this is $30.00x1.15=$34.50.

Now you have a competing proposal from building “B”, 10,000 RSF also at $30.00 per square foot only with a 13% core factor.  10,000/1.13=8,849.56 USF; $30x1.13=$33.90 per USF versus building “A” at 8,695.65 USF; $34.50 per USF.  All other things being equal building “B” is the better value, netting you 153.91 additional usable square feet, 8,849.56-8,695.65=153.91.  Depending on the layout, this could mean an extra three 6x8 workstations or one additional office or needed storage.

Many factors go into making a determination on where to lease.  Building “A” may be the more desirable location or the larger core factor may include a common conferencing center, allowing you to forgo a large meeting room within your USF or a maybe a fitness center, allowing you to drop the gym membership etc.



The Project Manager or Broker

A quality consultant will help you evaluate the space and determine the best value for your needs.

What Moves You?

By R. S. Collins



Moving your office or perhaps opening a new one and not sure how to get started?  Here are some tips to keep you on the right track.



That old real estate adage Location, Location, Location still holds true but I’d have to add Timing, Timing, Timing as equally, if not more important these days.  When considering a location there are many factors to consider.  What’s driving the need for a new office? Are you looking for space that is more Client Centric or Employee Centric?  Maybe you need to be closer to your primary market or your looking for an amenity-rich area that will help you attract and retain quality employees.   Combination of both may be a win-win.  Give yourself plenty of time to work through the process.  Depending on your needs it can take months, not weeks to get a space prepared for move in.  My typical client takes about eight months from identifying a need for space to actually moving in.  Obviously, this varies greatly, if you stumble upon a space that fits your needs right out of the gate the space no longer drives the timing.  This is a rare scenario.  Once you find your space and have negotiated a lease the real fun begins.  Design, Permit, Construction and tenant activities will determine the ultimate move date.  Short deadlines may have an adverse impact on your budget and quality.



Location drives costs.  An amenity-rich area with good transportation tends to be higher priced than perhaps a suburban office park with ample parking but few amenities and weak transportation options.  One way to beat the cost and still wind up in that desired location is to look at older Class “B” office where the rents might be lower but you can still get a Class “A” buildout.  Often Landlords with an older building will offer favorable lease concessions to compete against new product.  Lower rents and nice tenant improvement (TI) packages.  “B” rents with “A” buildout can be an appealing option.



Envision the “End Game” before you begin your search.



Determine Space and Budget Requirements:

Budget

Head Count

Future Growth

Office Intensive versus Open Plan

               Conference Rooms

               Training Rooms

               Collaboration Areas

               Game Room

               War Room

               Copy and Printing Needs

               Storage

               Kitchen

               Security

               Connectivity

               Audio Visual Requirements

               Power – Standard office verses special requirements which might include backup power

               HVAC – Standard or enhanced for heavy heat loads such as a LAN Room or 24/7 operation

               Access – Normal Business hours or 24/7



Lease Structure:



              Full Service

              Net

              Industrial Gross

              Term

              Free Rent

              Tenant Improvements

              Turn Key or Allowance



The above list plays into how big the space needs to be and the building type, lease structure, and concessions.  For example, a Flex Building’s rent will be net of certain costs such as utilities and janitorial and adds in the prorated share of common area (CAM) expenses, taxes, and insurance.  This has a lower base rent because it shifts certain costs directly to the tenant.  The flip side is it gives the tenant more control over access, HVAC systems, utilities and maintenance of your space.  Full-service rates include a base year amount that captures all the costs of operating the building.  The tenant does pay for the year over year increases in the operating cost component of the rent but does not pay directly for utilities and common area maintenance (CAM).



A Full-Service lease does not afford the tenant as much control.  For instance, in most cases, the HVAC system does not operate outside of the normal business hours as defined within the lease.  If you require work after hours to get a proposal out you will have to schedule that time with the landlord and pay an hourly rate for the privilege of working late.



Typically, the longer the lease term the more favorable the concession package will be.  Larger tenant improvement dollars, more free rent ectara.   Most leases run in the 5 to 10-year term.



I’m not going to get into the different ways to measure space but to say there is a big difference based on the building and lease type being offered.  For your needs, you should understand the differences to enable a fair comparison of spaces.  The basic terms are Rentable, Useable and Gross.  Useable is just what it sounds like.  The usable will determine if you fit or not.  The Rentable is what you pay rent on which includes common areas and amenities such as a fitness center accessible without membership to all the tenants.  You should refer to my past blog on “Understanding Core Factors and Why You Should Care”



Location Requirements:



              Proximity to Restaurants

  Shopping

              Affordable Housing

              Hotels

              Walkability

              Connectivity

              Public Transportation

              Parking

              Proximity to Clients

              Ease of Commute

              Security

              Rooftop Patio

              Fitness Center



It is no secret, location is the biggest differentiator in determining rental rates.  Identify the area you need to be in based on your employee and client drivers.  I highly recommend engaging a professional commercial real estate broker to help with your search.  The broker knows the market, will arrange for tours, find the vacancies and understands the expectations of the market, rent, concessions, and lease structure.  A quality broker will be able to help you define your corporate needs and translate them into a building and lease structure that makes sense for you.



Timing:



              Current Lease Term

Understand holdover implications

  Site Selection

              Lease Negotiation

              Design

              Permit

              Construction

              Tenant Activities:

                           Furniture Procurement

                           IT Infrastructure

                           Internet and Phone Service

                           Suite Access Control

                           Move Coordination

                           Business Interruption

                           Copy and Printing Needs



There are lots of variables that can have a positive or negative impact on schedule, most of which will not be fully flushed out until you have identified a site or at least developed your short list.  Once the shortlist has been developed and existing conditions, market, and jurisdictional issues identified you can get a better handle on design and construction schedule and costs.  In some markets, the lead-time for just ordering your Primary Rate Interface (PRI) from your phone/internet provider can be up to 45 days.  If your choice of spaces requires construction the design process is 8 weeks and the permit process can be another 8 to 10 weeks or more.  At this point, we are at 5 or 6 months and your buildout has not started.  8 weeks for construction and now 8 months after starting the process you are ready to move in…… Whew! Time is not on your side, this typical schedule will be impacted by the type of Lease, Size of Space, Design Elements, Long Lead Items such as HVAC, Special Finishes, Inspection and coordination of Tenant activities, your Business activities.  You may be an account that can’t move during tax season or a government contractor up against a proposal deadline.

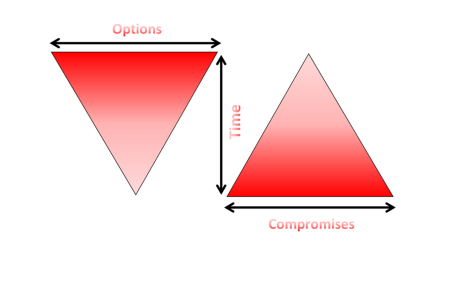

The above graphic is to illustrate the impact of timing on options.  The shorter your timeframe the fewer and fewer options you have and the greater the number of compromises you will make.  A professional Project Manager (PM), well versed in Tenant relocations, will be an invaluable member of your team.  The PM can greatly assist with budgeting, lease negotiations, as they relate to tenant improvements, scheduling and the procurement and monitoring of the budget, schedule, design and construction services, permitting, access control, furniture, IT Infrastructure, relocation services, and the very important quality control, just to name a few. A quality PM removes much of the day to day burden of planning and monitoring a relocation so you can focus on your core business.
